Water Education Center

Water Education Center Logo

Central Arizona Project Water Education Center is designed to deepen understanding and connect communities to the vital role water plays in Arizona’s future. Through interactive exhibits and hands-on learning experiences, the WEC will provide visitors of all ages with opportunities to explore the science, history and innovation behind water in the desert and the role of Central Arizona Project in this important story.

For more information about future field trip opportunities, please contact Renee McBride.

water education post screenshot thumbnail
READ MORE →
water education post screenshot thumbnail
READ MORE →

The walls are up and the bridge is complete … CAP’s Water Education Center (WEC) is becoming a reality on our Headquarters site in North Phoenix. Groundbreaking was one year ago and here’s a timelapse view of WEC rising out of the desert.

Architect/Experience Design: Jones Studio
Contractor: Mortenson

CAP 101 Exhibit Space
CAP 101 Exhibit Space
Future Water Education Center Exhibit Gallery
Future Water Education Center Exhibit Gallery
Conceptual rendering of the Water Education Center
Water Education Center Entrance

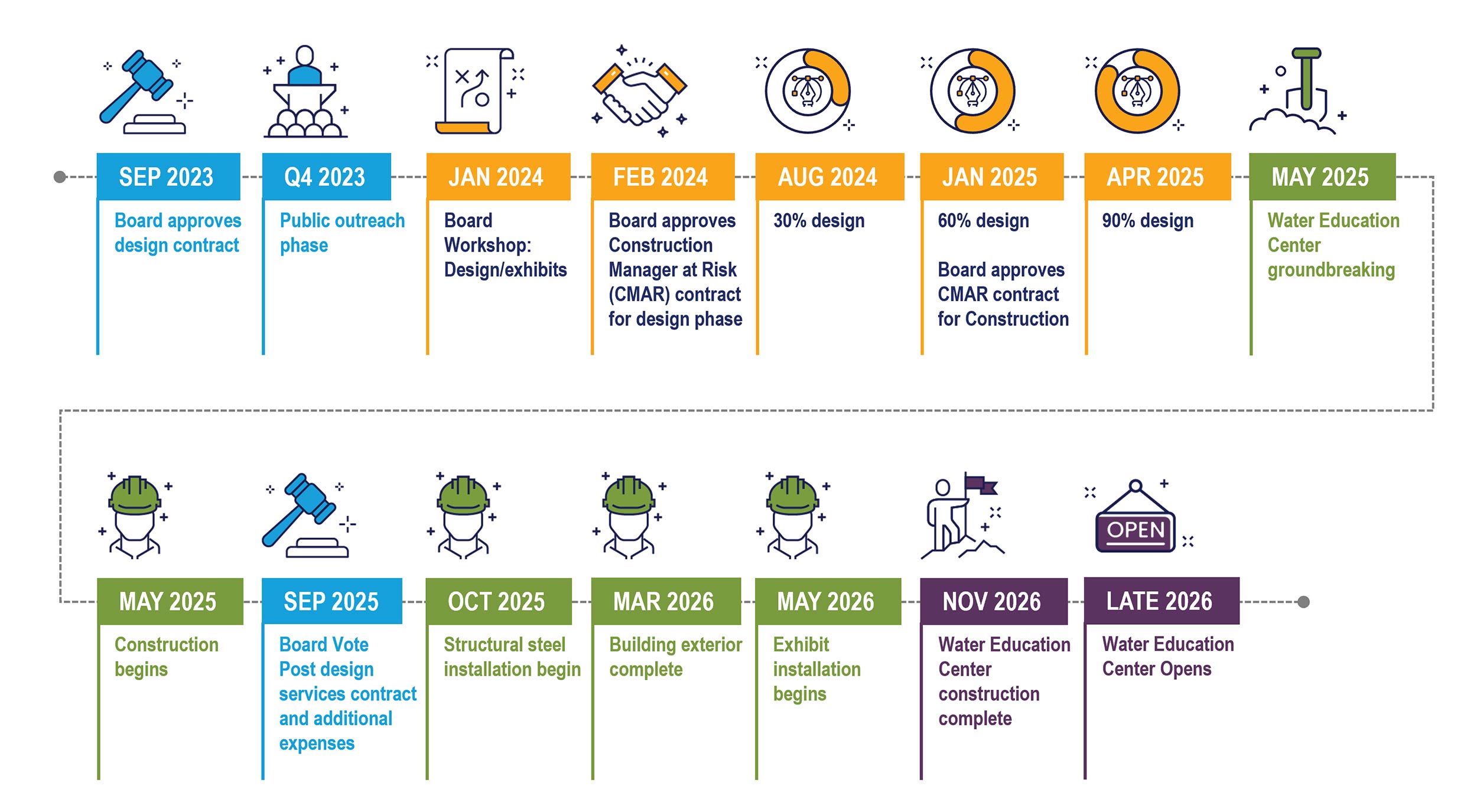

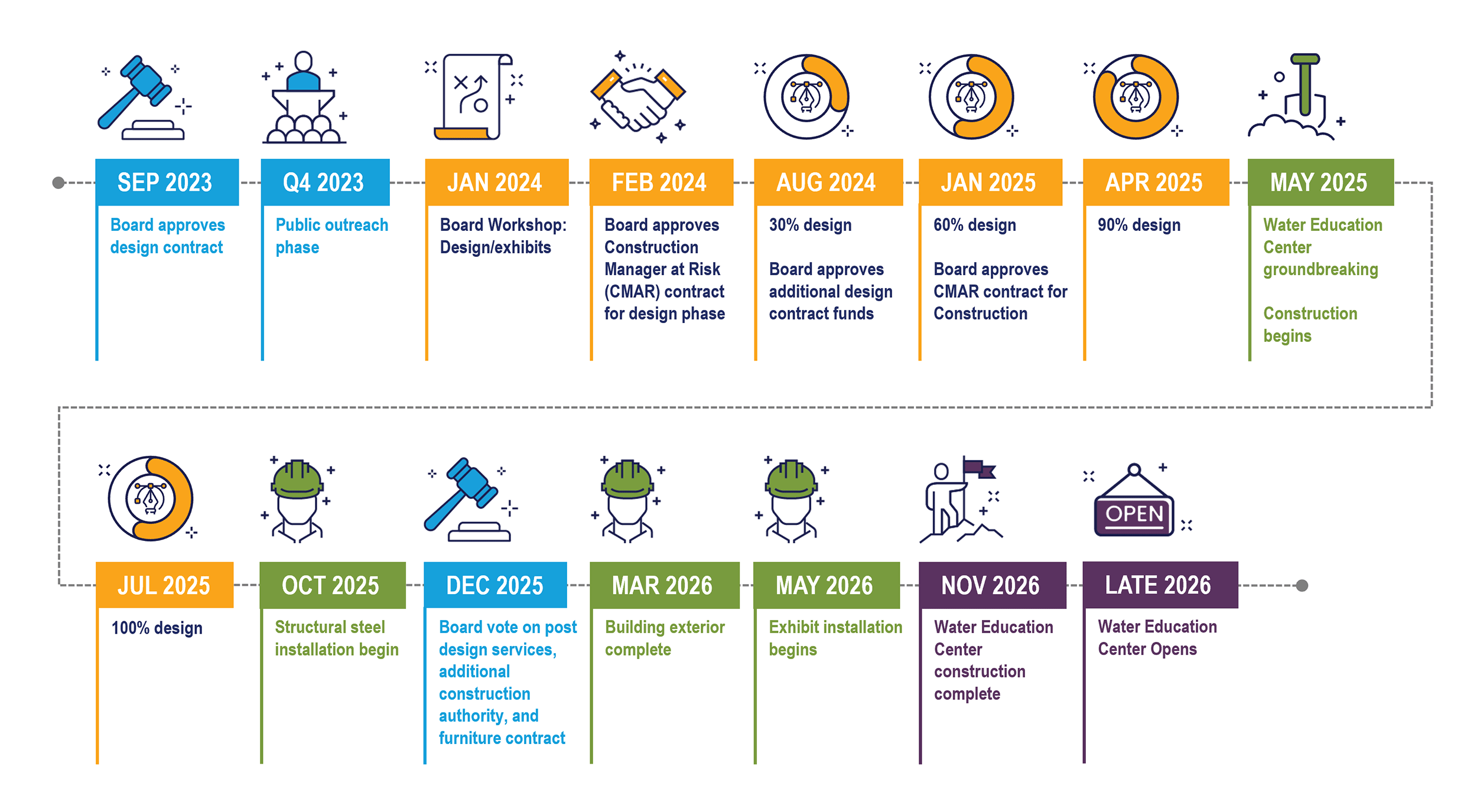

CAP Water Education Center construction timeline infographic
